Illustrative rooftop solar PV array on low rails across a pale factory metal roof

Built to hold
the sun.

Typical illustration

Sunrise Prima Sdn Bhd

The structure
behind solar power.

Sunrise Prima provides engineered solar mounting structures for solar PV installations in Malaysia. Established as the group’s solar arm in 2023, Sunrise Prima works in strategic collaboration with Solar Sentinel, combining structural engineering expertise with solar system design to support reliable and efficient solar PV installations.

Explore the presentation
Illustrative close-up of solar mounting rails, clamps and brackets
Typical illustration

A shared
energy ambition.

Sunrise Prima was established in 2023 to support Malaysia’s growing renewable energy sector with solar mounting structures.

Through a strategic collaboration with Solar Sentinel, Sunrise Prima combines structural engineering expertise with solar system design, supporting efficient and dependable solar mounting solutions.

Discuss a solar project

From structure
to solar system.

For the complete solar PV system, Sunrise Prima works in strategic collaboration with Solar Sentinel Sdn Bhd, which is also based in Telok Panglima Garang, Selangor.

Solar Sentinel’s services cover consultancy, design, supply, installation, and testing and commissioning of complete solar PV systems, including turnkey projects.

Power your site.

Explore the “Power Your Site” solar presentation.

The presentation includes illustrative operating models and calculations. Project sizing, commercial terms and savings need a site-specific assessment.

Power your site solar presentation

1 / 13 — Power your site

Open individual slides at full size

Inside the
solar proposal.

A text guide to the “Power Your Site” presentation.

The January 2026 presentation uses illustrative models and calculations. Confirm system design, applicable tariffs, commercial terms and approvals for your own site.

01 Two ways to power a site

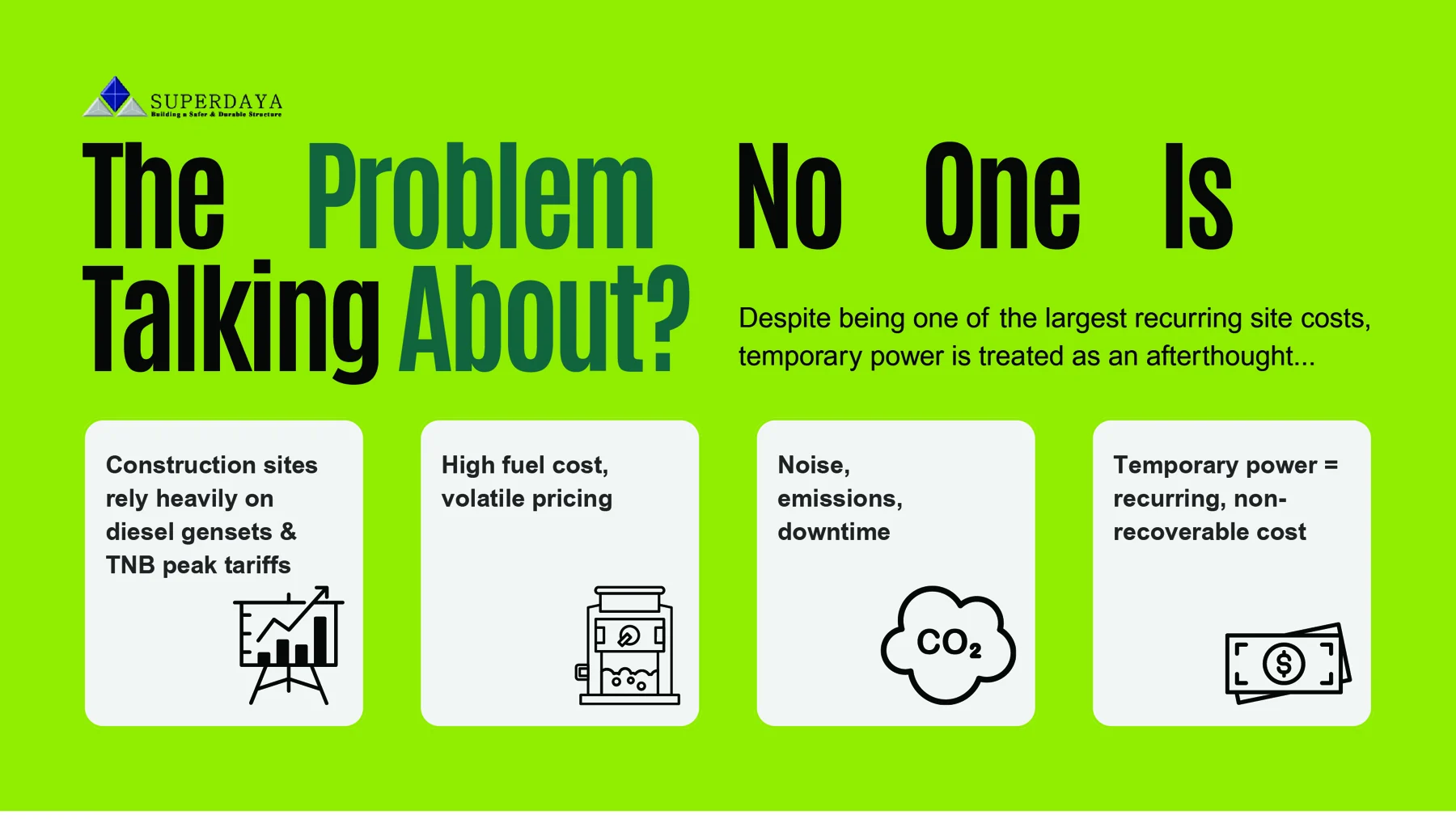

The presentation discusses reducing reliance on diesel generators and grid electricity, managing recurring energy costs, and limiting noise, emissions and downtime. Predictable energy costs and convenient deployment are intended benefits, rather than measured results for a named project.

Self-sustaining site

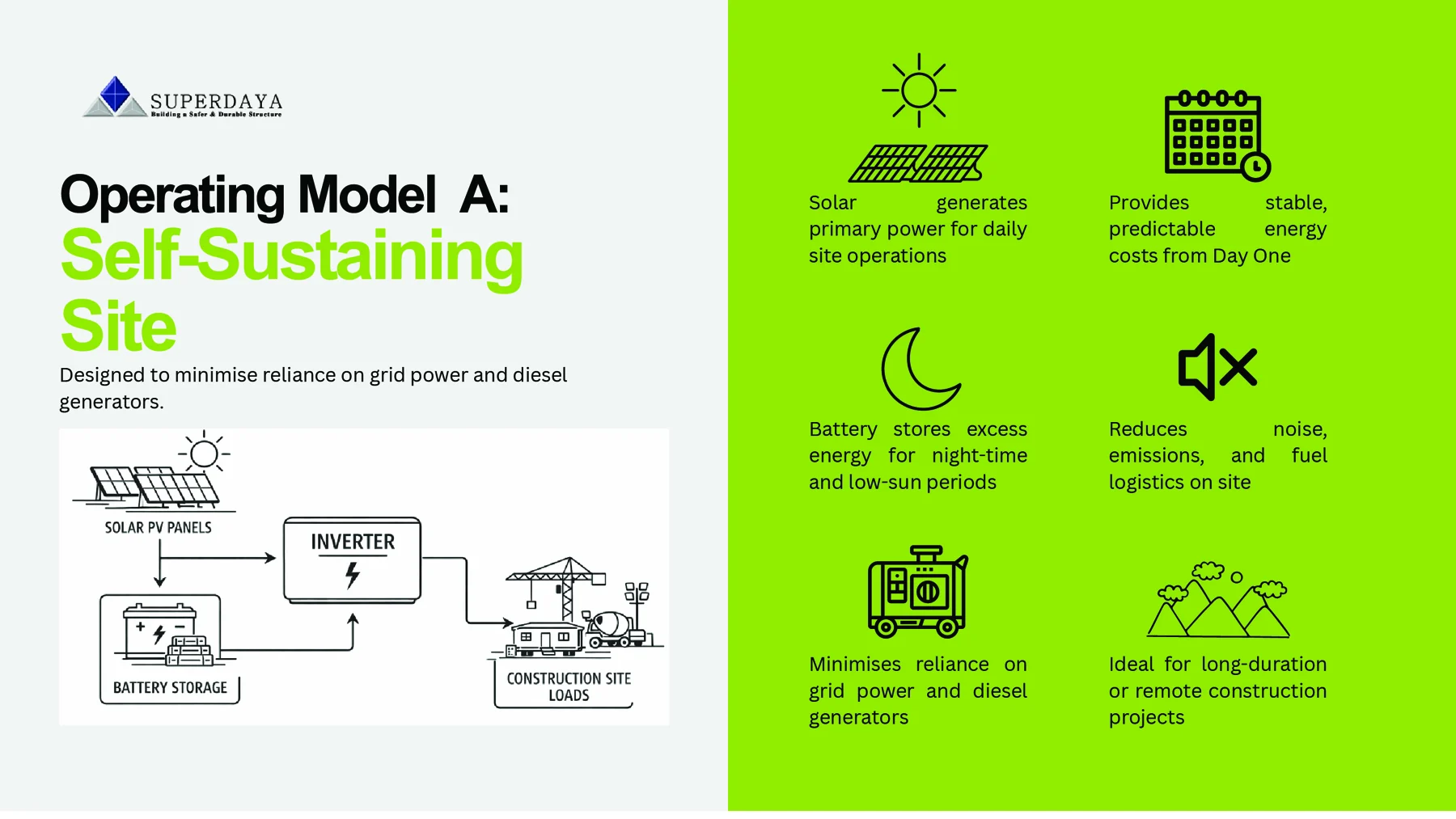

Model A connects solar PV panels, battery storage and an inverter to construction-site loads. Solar supplies daily operations while the battery stores excess energy for night-time and low-sun periods.

The presentation positions this model for long-duration or remote construction projects, with the aim of reducing grid and diesel reliance, noise, emissions and fuel logistics.

Peak shaving

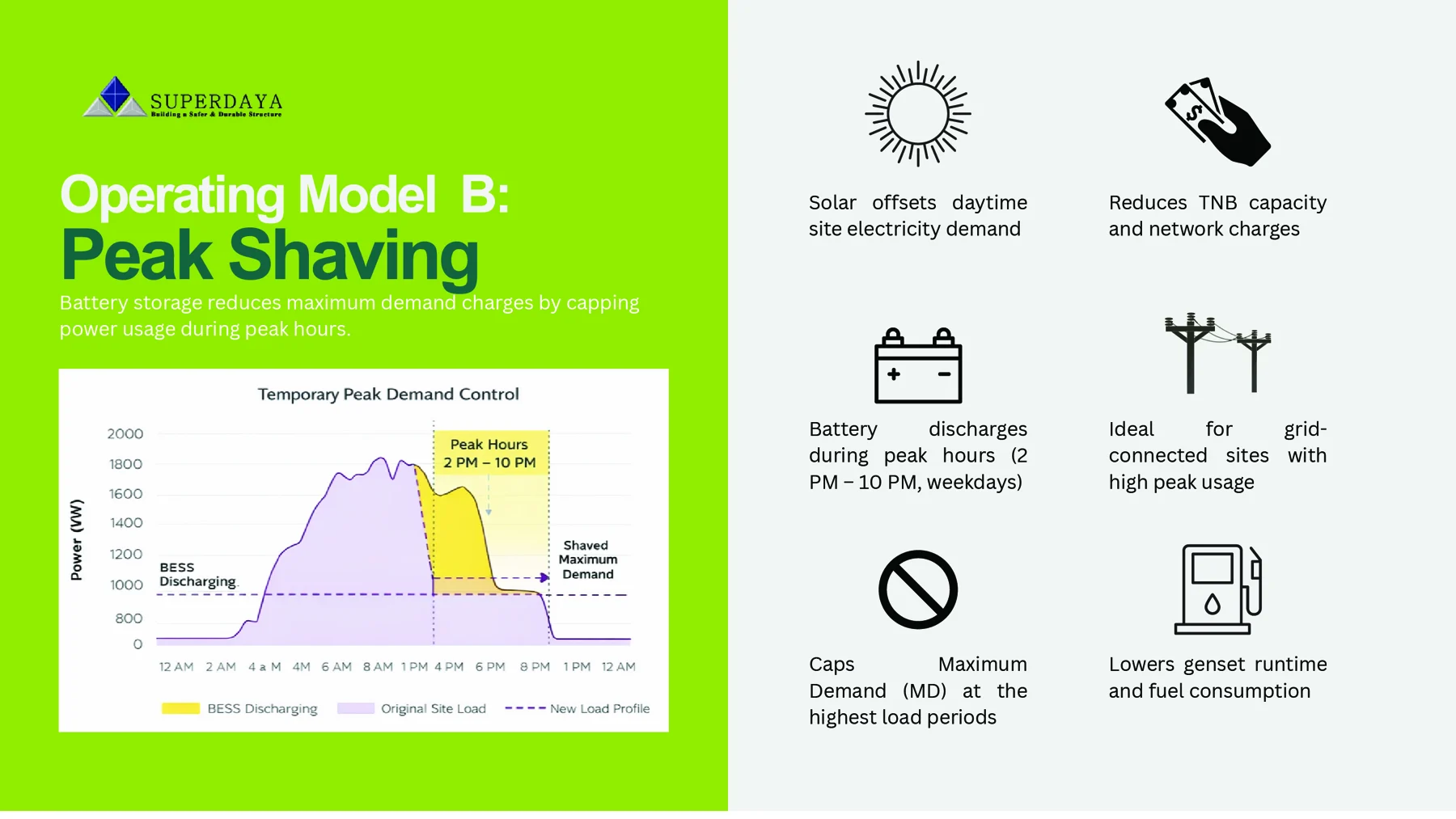

Model B uses solar to offset daytime demand, with battery discharge during high-load periods to cap maximum demand. The presentation assumes weekday peak hours of 2pm–10pm.

The model is presented for grid-connected sites with high peak usage. Changes in capacity or network charges, genset runtime and fuel use depend on the site and its applicable tariff.

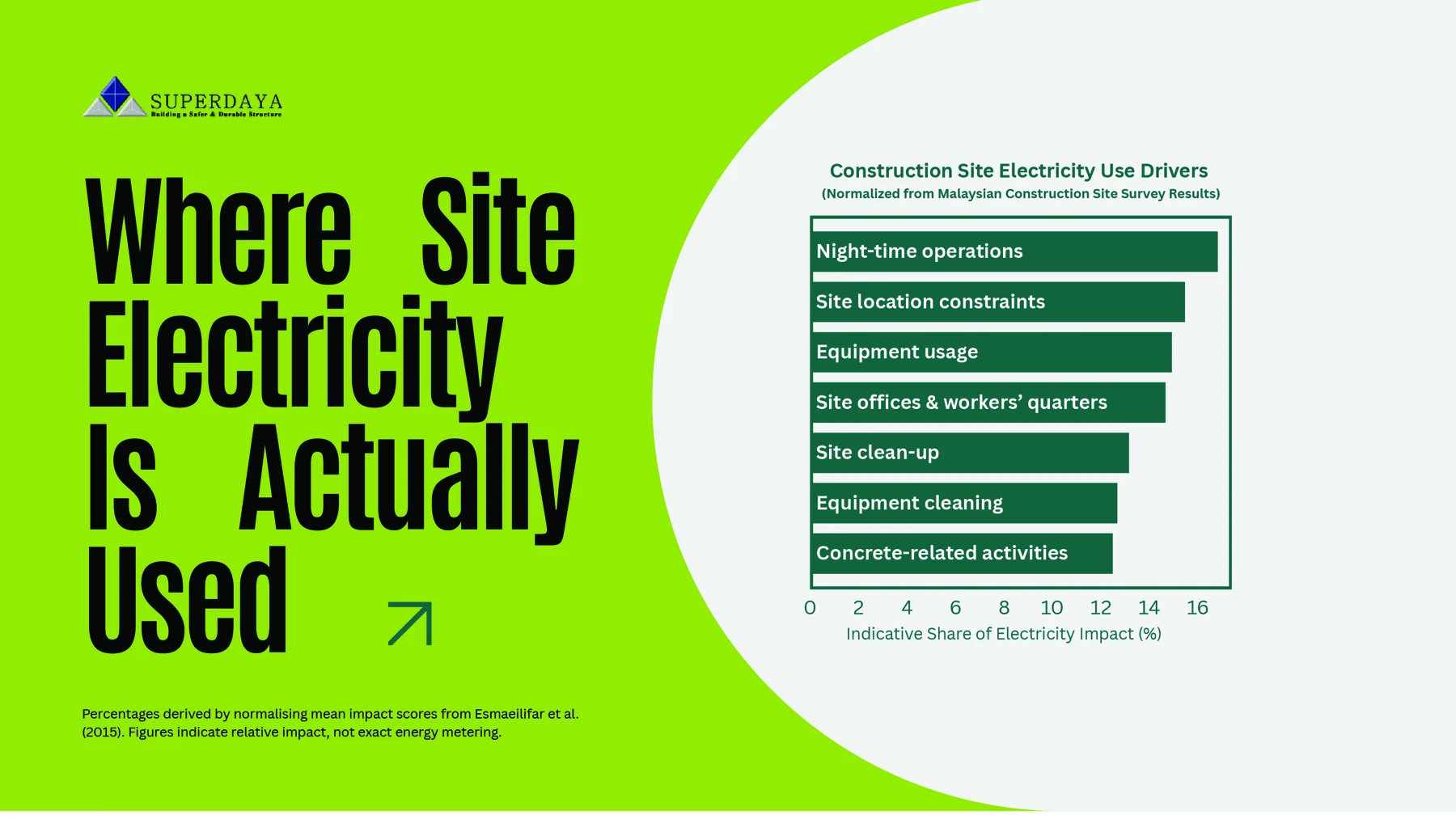

The source identifies night-time operations, site location, equipment use, offices and workers’ quarters, cleaning and concrete-related activities as electricity-use drivers. Its chart uses indicative relative impact rather than metered consumption, and attributes its normalised scores to Esmaeilifar et al. (2015).

02 A worked energy example

Estimate daily energy use

Slide 6 assumes a medium-sized construction site with 100–200 workers. This is a worked example, not a standard system specification.

Daily energy example from the presentation

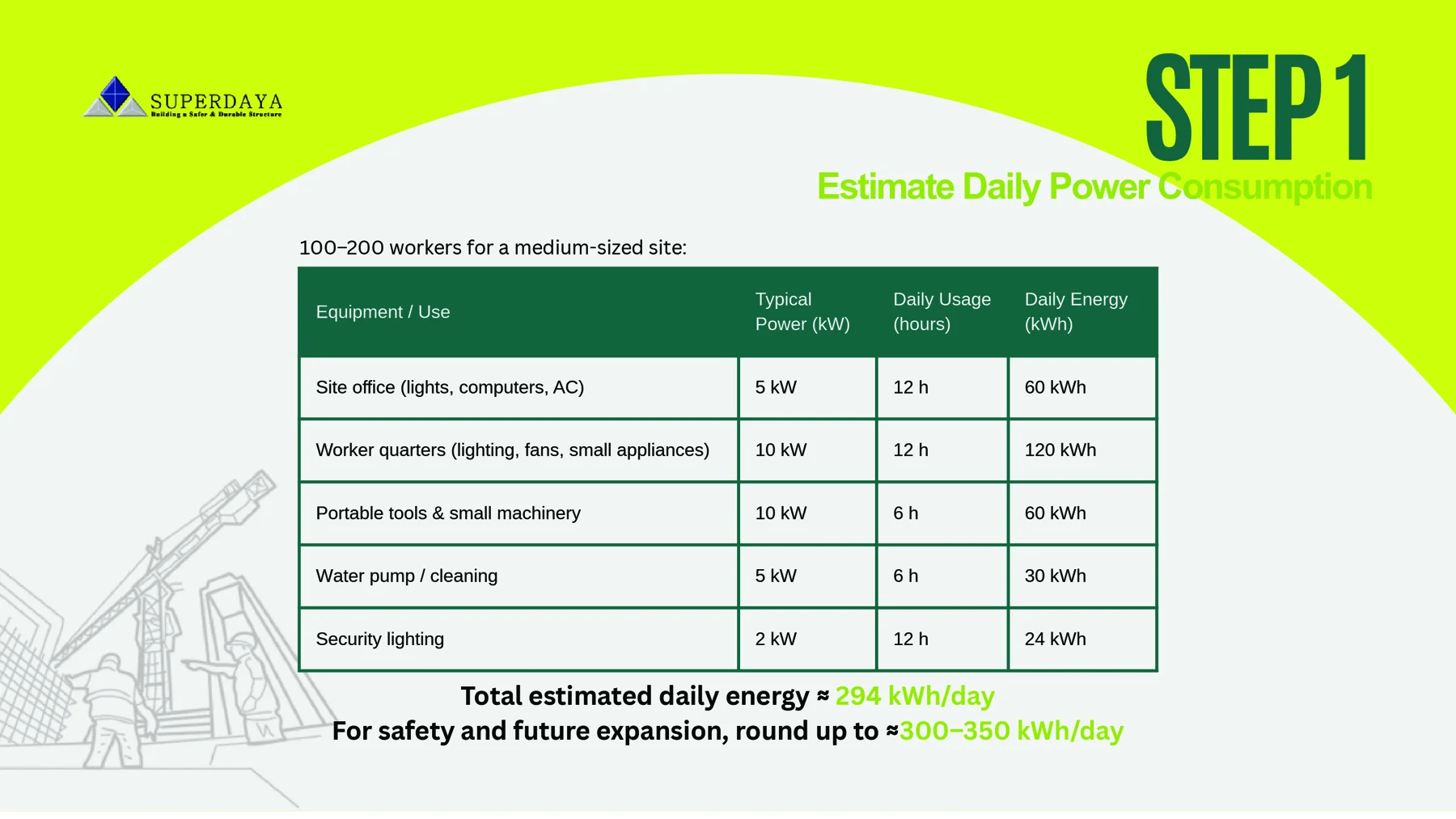

Equipment or usePowerDaily useDaily energy
Site office: lights, computers and AC5 kW12 hours60 kWh
Worker quarters: lights, fans and small appliances10 kW12 hours120 kWh
Portable tools and small machinery10 kW6 hours60 kWh
Water pump and cleaning5 kW6 hours30 kWh
Security lighting2 kW12 hours24 kWh
Total estimated daily energy294 kWh/day

The presentation rounds this example up to approximately 300–350 kWh/day for safety and future expansion.

Estimate solar PV capacity

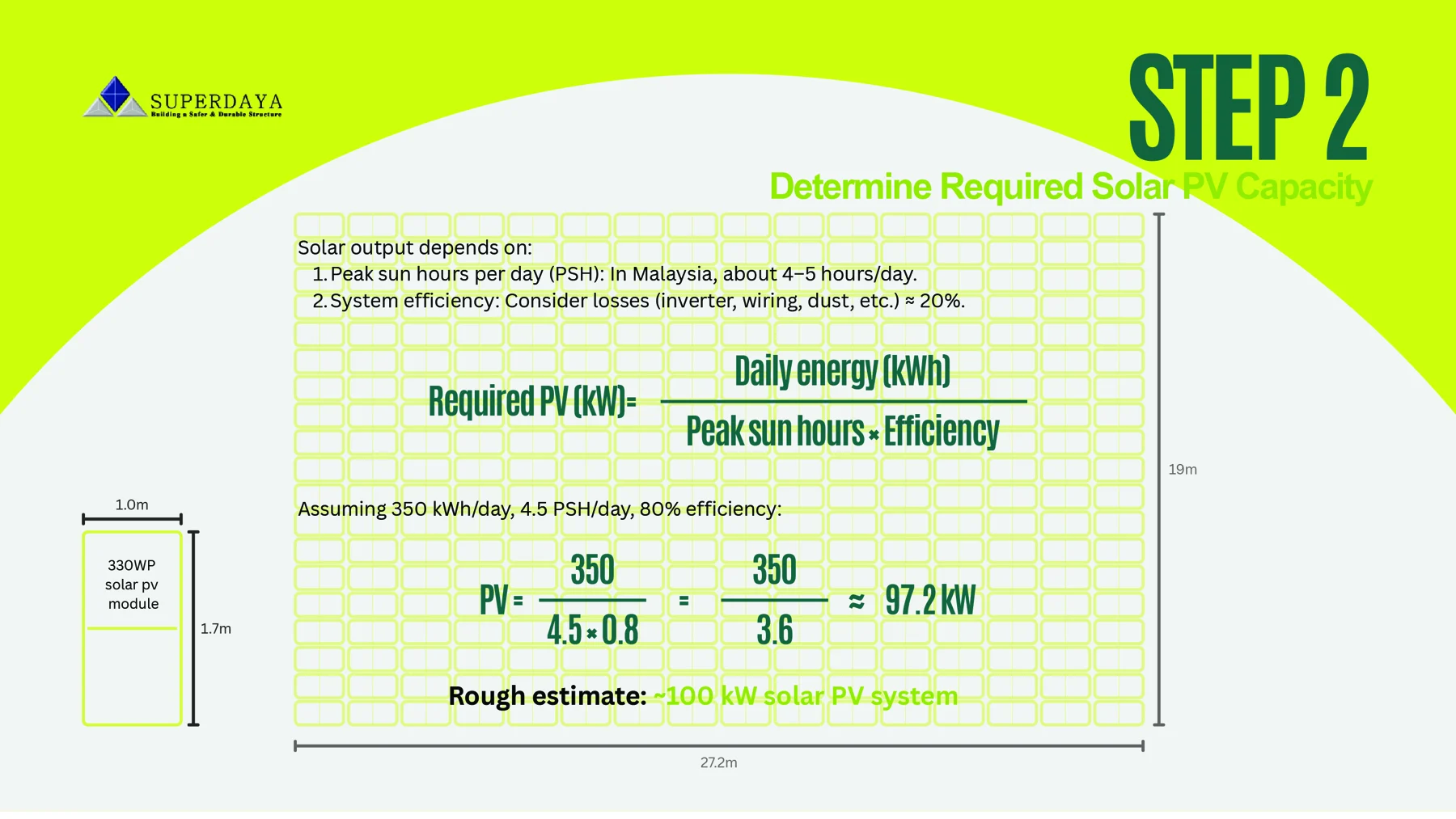

Slide 7 uses about 4–5 peak sun hours per day in Malaysia and allows approximately 20% system losses from the inverter, wiring, dust and other factors. Its formula divides daily energy by peak sun hours multiplied by efficiency.

350 kWh/day ÷ (4.5 hours/day × 0.8) ≈ 97.2 kW

The presentation rounds this to a 100 kW solar PV example. Its illustration labels a 330 Wp module measuring 1.0 m × 1.7 m and an array footprint of 27.2 m × 19 m. These are illustrative dimensions, not a project layout.

Consider battery storage

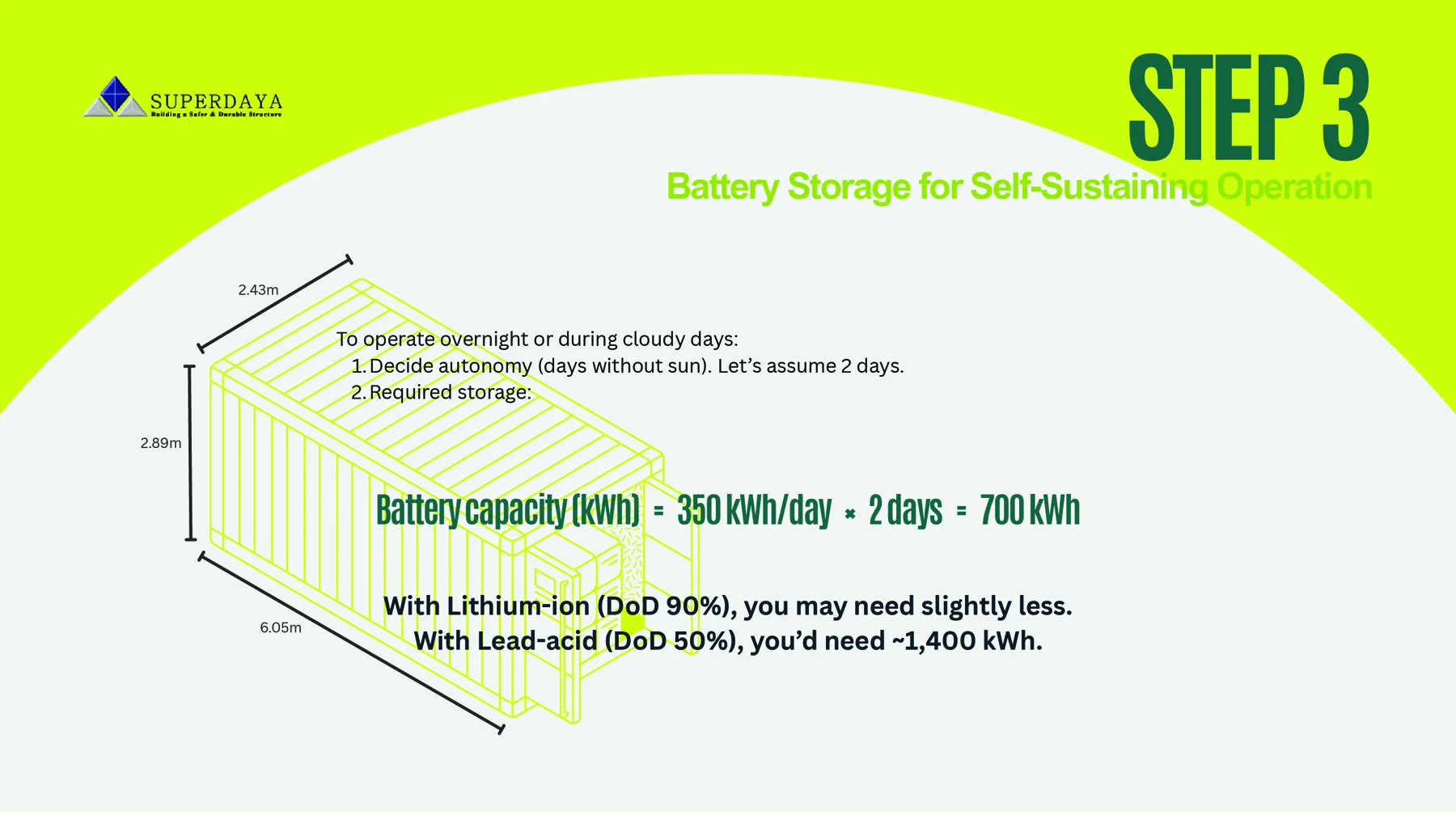

Slide 8 assumes two days of autonomy: 350 kWh/day × 2 days = 700 kWh. It separately discusses lithium-ion batteries at 90% depth of discharge and lead-acid batteries at 50%, with an approximately 1,400 kWh lead-acid example.

The source does not clearly distinguish usable from nominal capacity in its lithium-ion example. Confirm battery capacity, depth of discharge and reserve requirements with the project designer before sizing a system. The illustrated battery container is labelled 6.05 m × 2.43 m × 2.89 m.

03 Buy, lease and project support

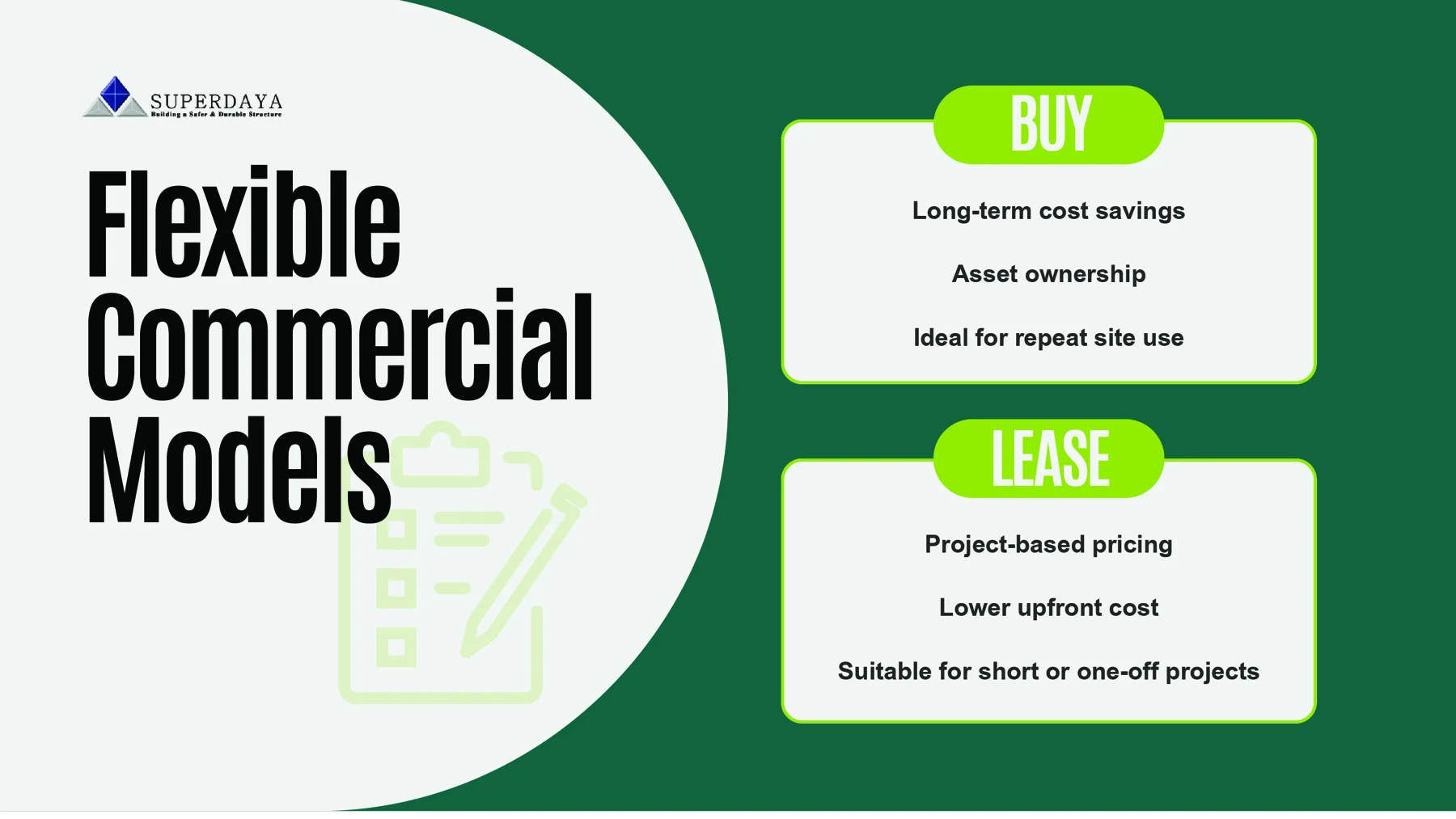

Commercial models described in slide 10
BuyLease
Asset ownershipProject-based pricing
Positioned for long-term cost savingsPositioned for lower upfront cost
Suited to repeated use across sitesSuited to short or one-off projects

Ask the team which options are available and request pricing and terms for your project.

Planning and coordination

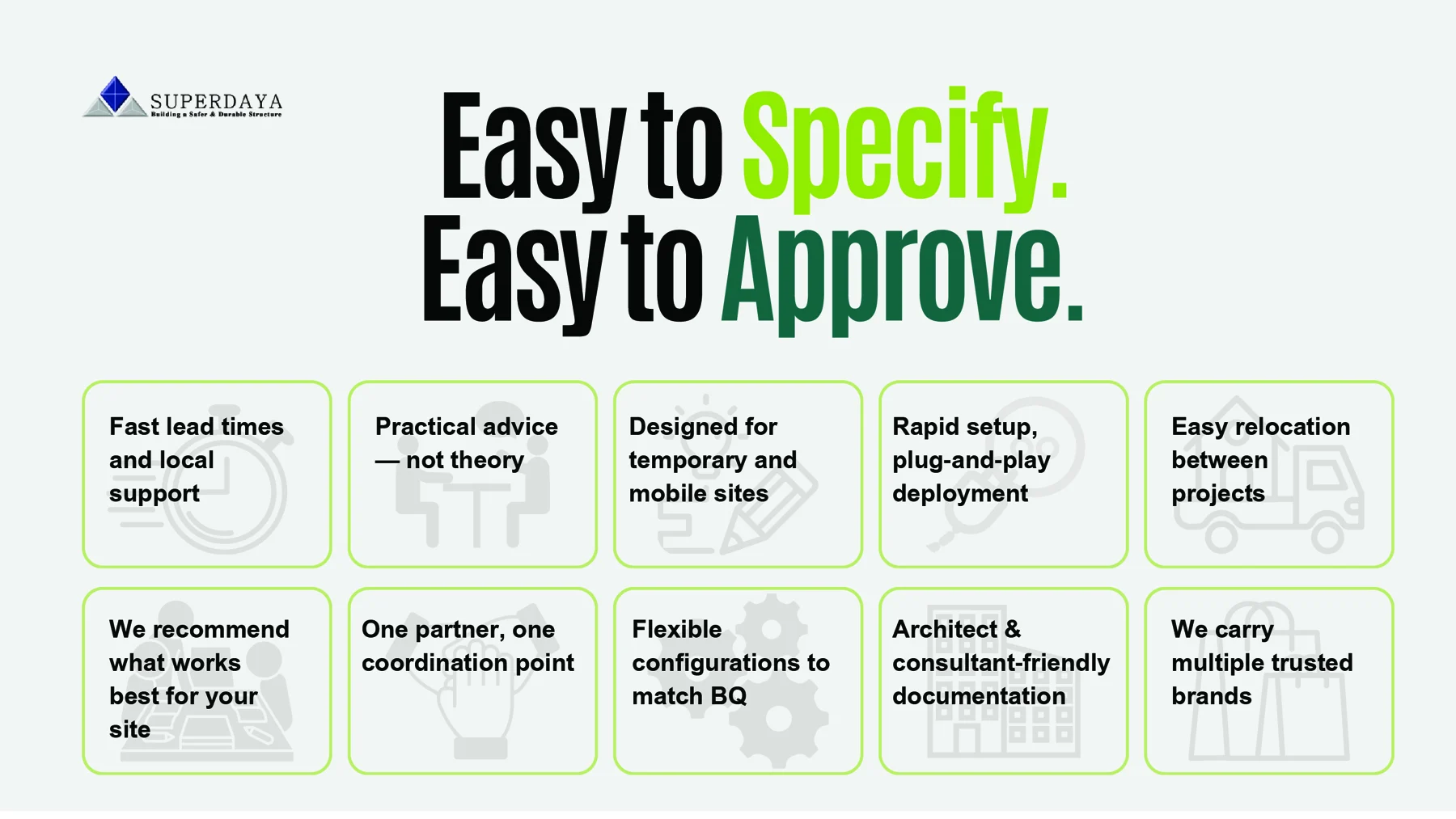

The presentation describes local support, practical site advice, one coordination point, configurations to match the bill of quantities, documentation for architects and consultants, and multiple brands. It discusses temporary and mobile sites, relocation between projects, and plug-and-play deployment.

Intended benefits include more predictable energy costs, stable power for equipment and offices, sustainability information to support tenders and approvals, and reduced noise and emissions. These are the presentation’s aims, not guaranteed tender outcomes or project performance.

04 What needs a site assessment?

Design around real conditions

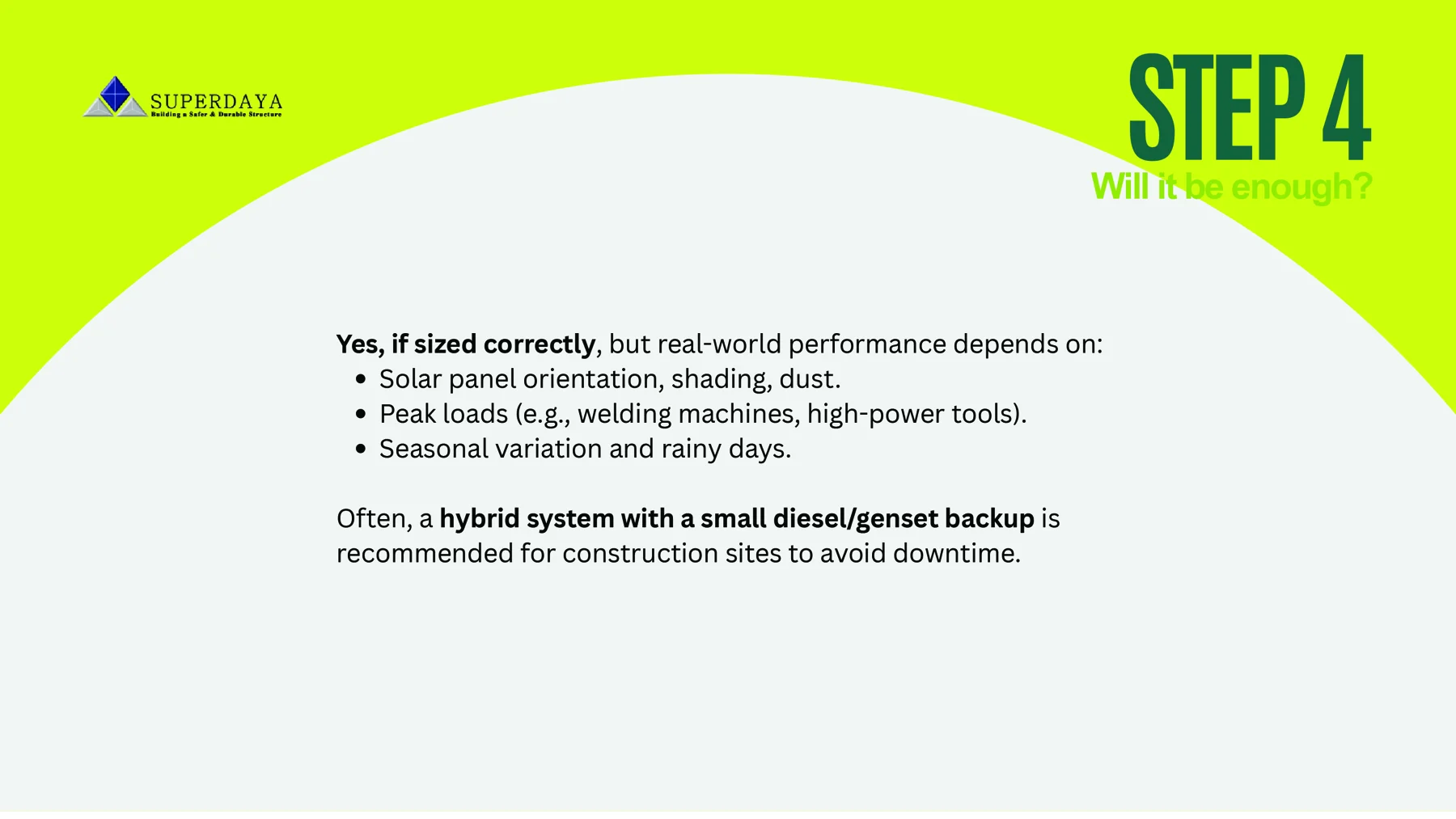

The presentation says performance depends on panel orientation, shading, dust, peak loads such as welding machines and high-power tools, seasonal variation and rainy days. It discusses a hybrid system with a small diesel or genset backup as an option for construction sites.

Agree the installation programme

The setup slide covers site preparation, installation and commissioning, approval considerations and power availability aligned with the construction programme. It does not establish a quantified installation duration. Confirm preparation, approvals, delivery and commissioning requirements with the team.

Contact Ducero with the site location, expected loads and project requirements to discuss the next step.

Discuss your site

Questions
we are asked.

What does Sunrise Prima do?

Sunrise Prima Sdn Bhd provides engineered solar mounting structures designed to support reliable and efficient solar PV installations. It was established in 2023 as the group’s solar arm to support Malaysia’s renewable energy sector, and works through a strategic collaboration with Solar Sentinel, which brings solar system design alongside the group’s structural engineering expertise.

What is the difference between a self-sustaining site and peak shaving?

In the “Power Your Site” presentation on this page, Model A, a self-sustaining site, uses PV panels, an inverter and batteries to run construction loads, including at night and in low sun, and suits long or remote projects. Model B, peak shaving, offsets daytime demand and discharges batteries during high-load periods, and suits grid-connected sites with high peaks.

Are the figures in the solar presentation a guarantee?

No. The presentation’s numbers, such as a medium site using about 300 to 350 kWh a day and a system of roughly 100 kW at 4.5 peak sun hours, are worked examples. Orientation, shading, dust, peak equipment loads and rainy seasons all change real performance, so every system needs a site-specific assessment before sizing, pricing or savings are discussed.

Can a solar system be bought or leased?

The presentation describes two routes. Buying suits owners who want the asset and will reuse it across sites. Leasing suits short or one-off projects where a lower upfront cost matters. Availability, pricing and terms for either route are confirmed with the team for each project, so contact Ducero with your site details.

Illustrative solar technicians checking a rooftop PV array
Typical illustration

Let’s talk
solar.

Contact Ducero for roofing, steel profiles or solar mounting structures. Share your project location and the work you have in mind.

Start a conversation

Shaping tomorrow.

WhatsApp us
